Power Lines

Wishing Star to Mars

Construction is underway to connect the new Mars and Wishing Star substations. Dominion Energy submitted its application to the Virginia State Corporation Commission (SCC) on October 27, 2022, and received approval on April 5, 2023.

Project Details

You and your community rely on safe, dependable electricity as Northern Virginia grows. Energy demand is rising quickly, driven by Loudoun County's role as one of the world's leading innovation and technology hubs. To keep pace, Dominion Energy is planning and building new transmission infrastructure in partnership with county, state, and community leaders.

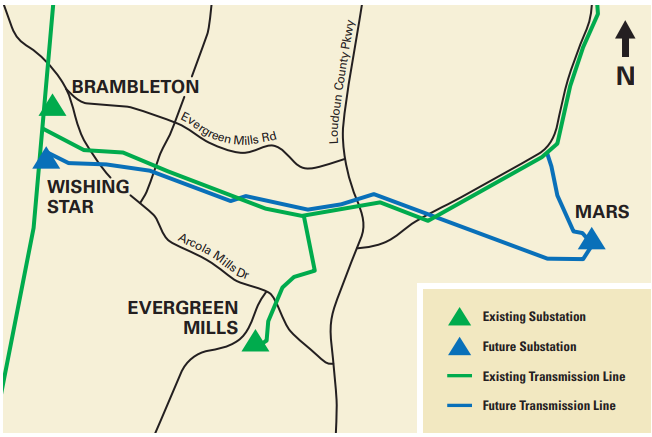

Overview map This map is intended to serve as a representation of the project area and is not intended for detailed engineering purposes.

What Matters to You?

Explore GeoVoice, an interactive mapping tool. You can:

  • Search for your address
  • Explore proposed project routes
  • Send comments to the project team
Structure Comparison Tool or GeoVoice cta btn

What To Expect

2026

May 2026
Construction Complete
February 21, 2026
OH Temporary Bypass Energization
January 2026
500 kV GIS Energized

2025

December 2025
Energization Issue

Legal

The Virginia State Corporation Commission (SCC) has regulatory authority over all energy providers in Virginia. Among other responsibilities, the SCC validates the need for a proposed line and approves the route and structures. In reviewing a proposed project, the SCC must consider whether potential impacts on scenic assets, historic districts and the environment have been reasonably minimized.

On October 27, 2022, Dominion Energy filed its application with the SCC. Documents related to the case are available to the public on the SCC Docket of the SCC website or search by Case No. PUR-2026-00050 in the “ Search Cases “ section. In addition, interested parties may visit the SCC Case Comments Page where individual mailboxes are available for each case accepting public comments. Please note, the mailbox may not be available until a scheduling order is issued, typically several weeks after an application is filed.

SCC Documents

SCC Timeline

  • April 5, 2023 - Final approval
