Balcony Falls - Skimmer
Project Details
Built in the 1920s, two 115 kilovolt (kV) transmission lines need to be replaced to maintain electric reliability. The lines are in a 9.2-mile right of way corridor that runs through Rockbridge, Amherst and Bedford counties. The existing wooden H-frame and steel lattice structures will be replaced with a combination of brown, weathering steel H-frame and steel pole structures.

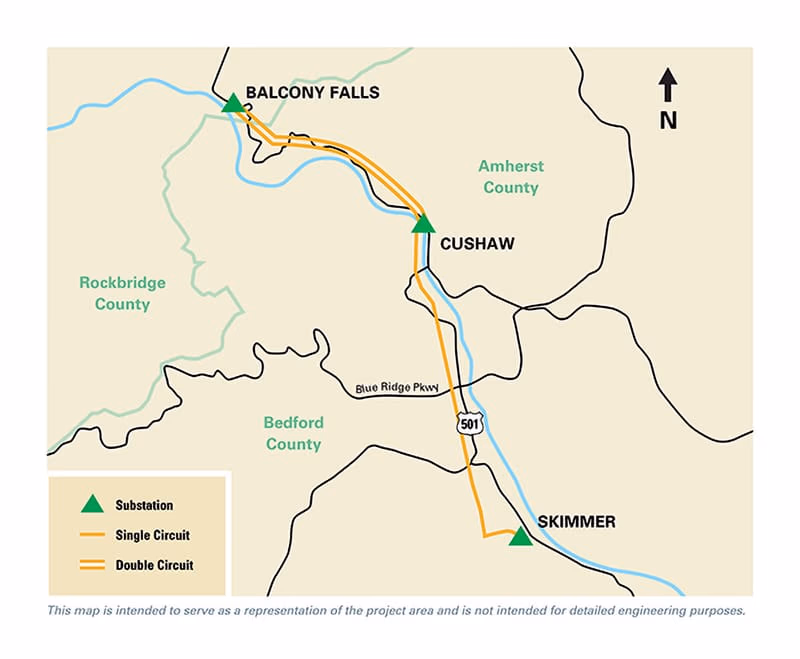

- Project area is 9.2 miles long
- Right of way width is primarily 125 feet wide with some 100-foot sections
- Average H-frame structure height is 46 feet
- Average lattice structure height is 80 feet
- 85 structures in the corridor
- Average height of structure in double-circuit section from Balcony Falls-Cushaw is 94.2 feet
- Average structure height in a single-circuit section from Cushaw-Skimmer is 60.5 feet
- 74 total structures in proposed corridor
- Maximum structure height increase of 63 feet in Balcony Falls-Cushaw section
- Maximum structure height increase of 17 feet in Cushaw-Skimmer section
Community Engagement
Meetings
What to Expect
Timeline
2026
Spring 2026
Phase 2 Restoration
2024
Early 2024 - Spring 2025
Phase 2 Construction From Cushaw to Balcony Falls
2023
Spring 2023 - Summer 2023
Phase 1 Restoration
2022
Fall 2022 - Spring 2023
Access & Danger Tree Work Begins, Phase 1 Construction from Skimmer to Cushaw
March 2022
Preconstruction Community Meeting
2021
2020
March
Project Announcement
