Goose Creek
500 kV Substation Expansion
Overview

The Goose Creek 500 kilovolt (kV) Substation Expansion Project installed new electric transmission equipment at our existing Goose Creek 500 kV Substation in Loudoun County, Virginia. Northern Virginia, especially Loudoun County, is experiencing increasing energy demands which is driving the need for additional capacity in the electric transmission system to ensure reliability and resiliency for all customers. This project will improve electric reliability for all customers in the area.

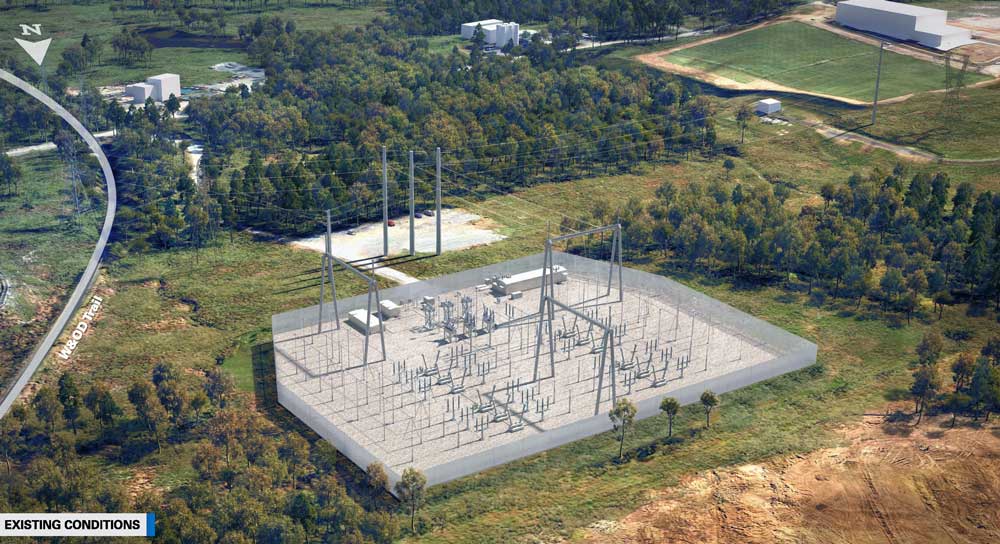

The substation's existing footprint expanded southward on Dominion Energy owned property to accommodate new equipment. Pre-construction activities, including site preparation and vegetation management, began in late 2022. Construction began in early 2023 and ended as scheduled in December 2023. The Goose Creek Substation Expansion Project is co-located with two other substations.
Day and night site preparation activities started in late March. We performed earthwork activities. Rock may need to be broken up as part of the site preparation, and that can be nosier than simply moving the topsoil layer. Rock excavation activities occur weekdays between 7:00 a.m. and 9:00 p.m. and on weekends between 9:00 a.m. and 9:00 p.m. only. Other site preparation activities continue overnight. We completed site preparation in June.
The W&OD Trail is located northeast of our substation. Trail users will notice activity, but we do not anticipate any impacts to the trail as a result of this substation project.
Benefits
- Maintains current right of way
- Complies with mandatory standards to ensure safety, reliability and to meet future needs
- Minimizes impact to the community and environment
Documents


FAQs
The W&OD Trail is located northeast of our substation. Trail users will notice activity, but we do not anticipate any impacts to the trail as a result of this substation project. However, there is another electric transmission line project occurring in this area along the W&OD Trail in 2022 and 2023. To learn about those impacts, visit DominionEnergy.com/Belmont.
We are committed to continually reviewing and analyzing our energy infrastructure to provide safe, reliable, and affordable electricity to the communities we serve. Northern Virginia, especially Loudoun County, is experiencing increasing energy demands which is driving the need for additional capacity in the electric transmission system to ensure reliability and resiliency for all customers. This project addresses these needs and will improve electric reliability for all customers in the area.
No, the expansion is entirely within the existing Dominion Energy-owned parcel and uses the existing right of way.
Timeline
2023
December 2023
Project complete
Summer 2023
Begin substation construction activities—work occurs both day and night, as allowed
Spring 2023
Begin site preparation activities for the expansion area, including earthwork activities—work occurs both day and night, as allowed
Early 2023
Begin pre-construction activities, including site preparation and vegetation management
2022
December 1, 2022
Begin tree clearing activities
Construction-Related Impact

Service Interruption
Your electric service is not expected to be impacted by this project.

Traffic
This project is not expected to impact traffic.

Noise
Noise levels will be moderate; permits are in place.

Neighborhood
Access to surrounding neighborhoods will not be impacted.
